Concrete in the New

Storage Building

May 20th & 21st - Floor

June 18th, 19th & 20th - Approaches & sidewalks

Thank you to all involved!

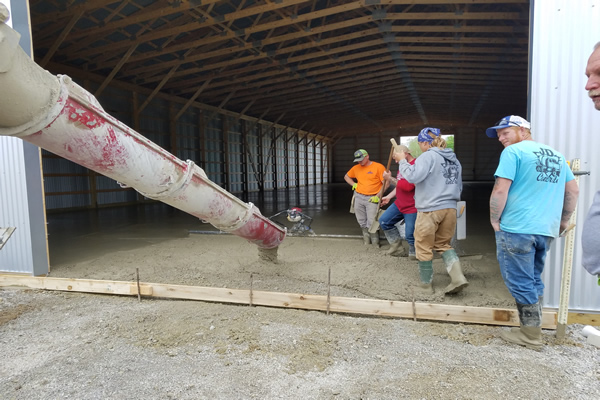

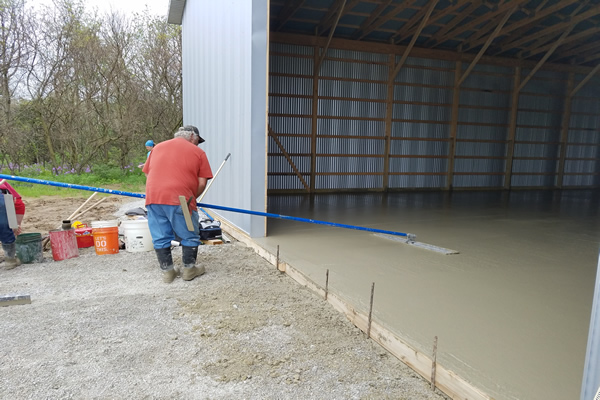

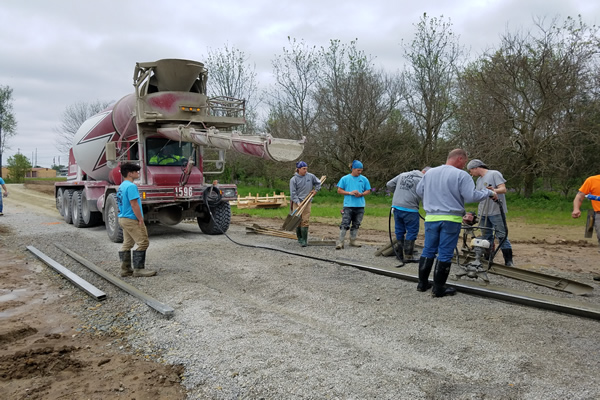

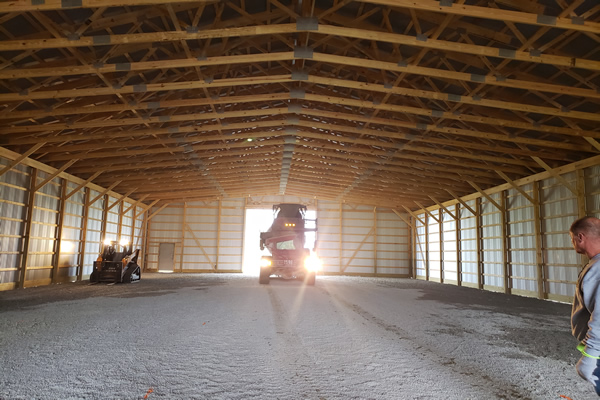

May 20th - The first concrete truck from IMI arrives .

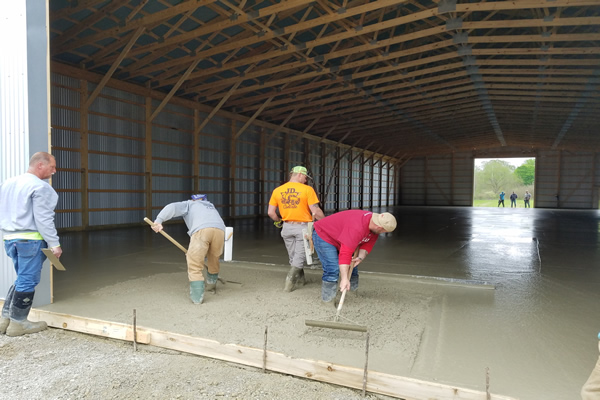

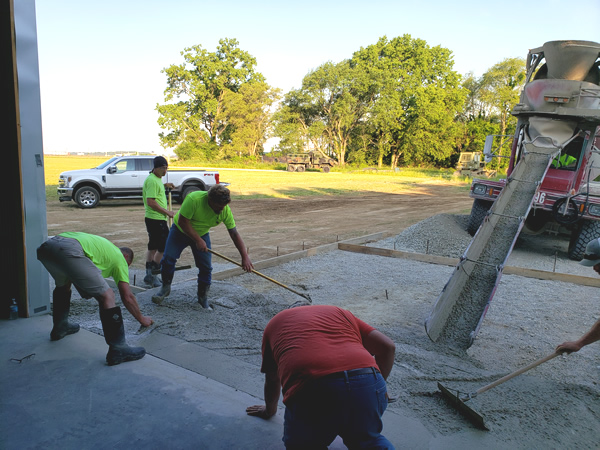

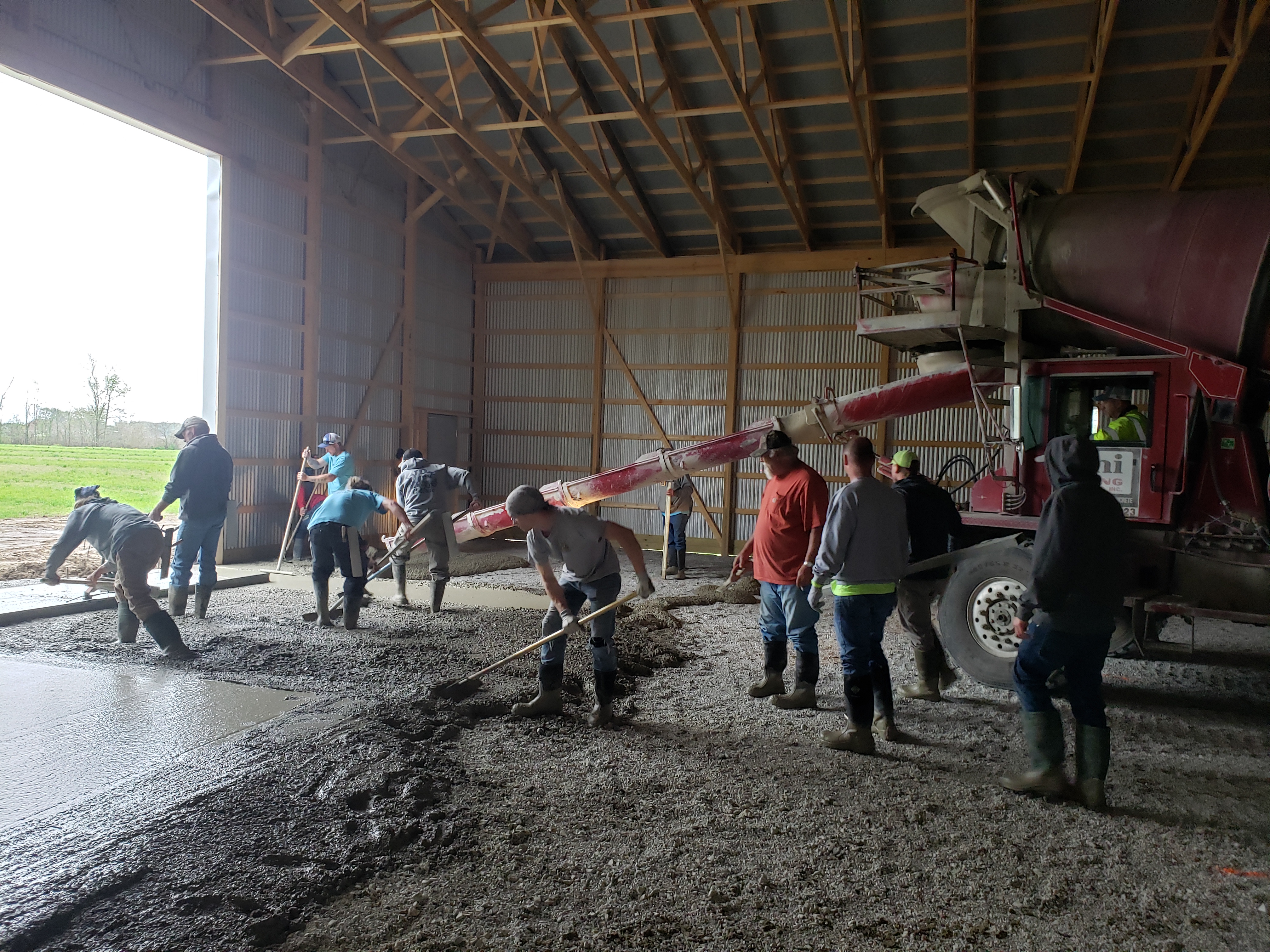

May 20th - Just before 8 a.m. We had quite the crew of volunteers from AAA Excavating & Concrete and JD Concrete working together to get this concrete job done.

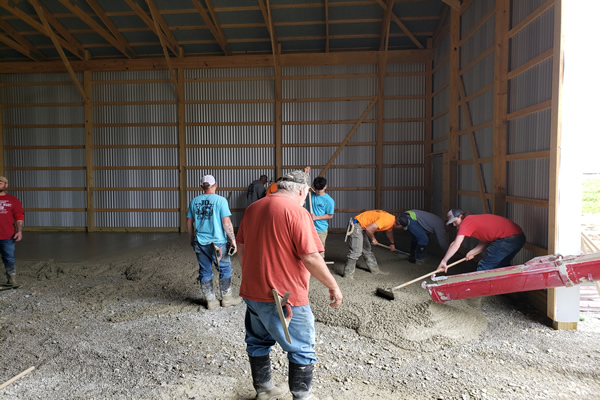

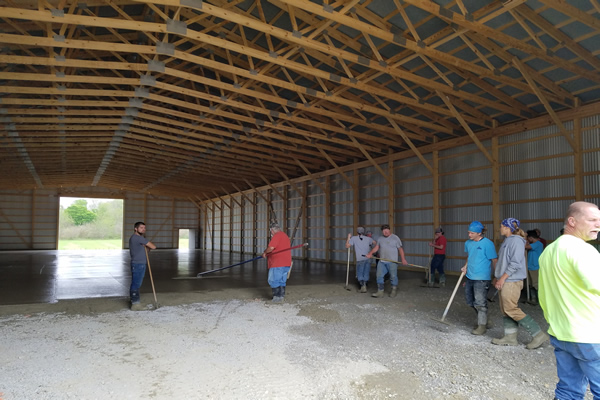

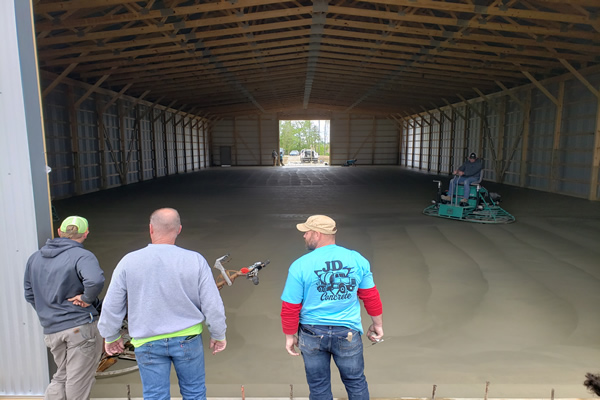

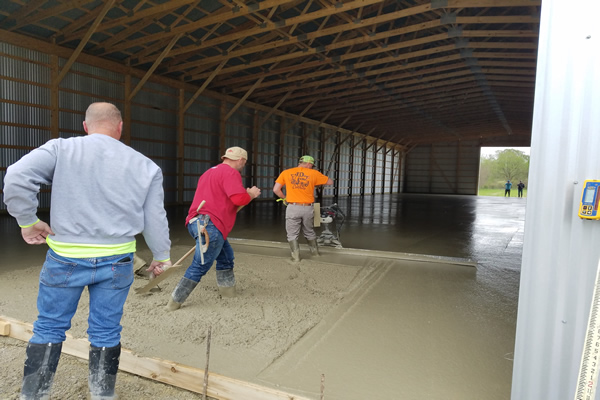

Mid morning and already half way through the building.

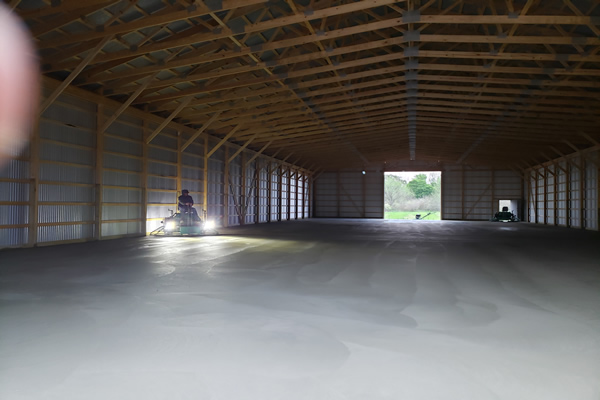

Glen Hall is a master with that float.

Crews from JD Concrete and AAA Excavating & Concrete cleaning their tools.

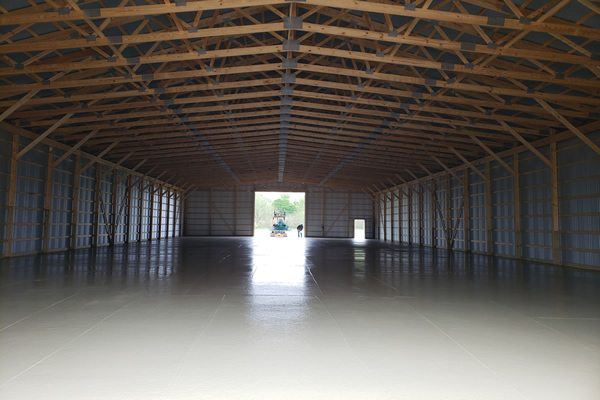

By noon all the concrete was in.

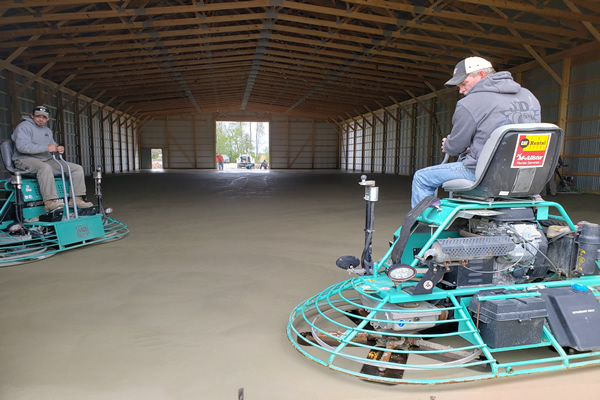

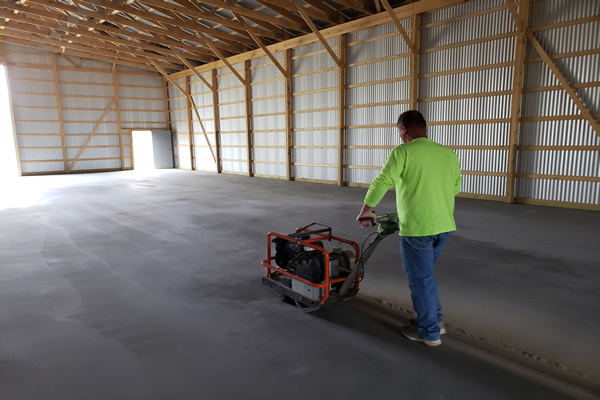

At 2 p.m. they were finishing the surface of the concrete

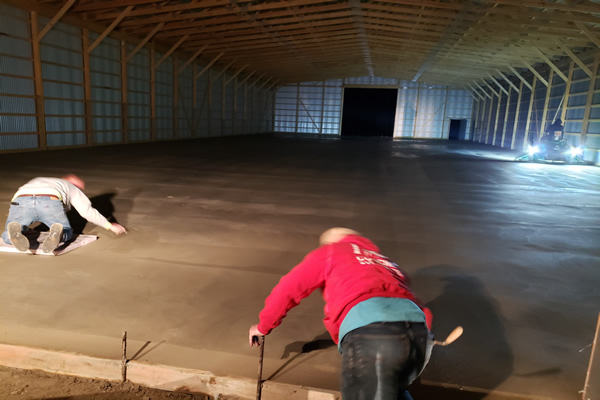

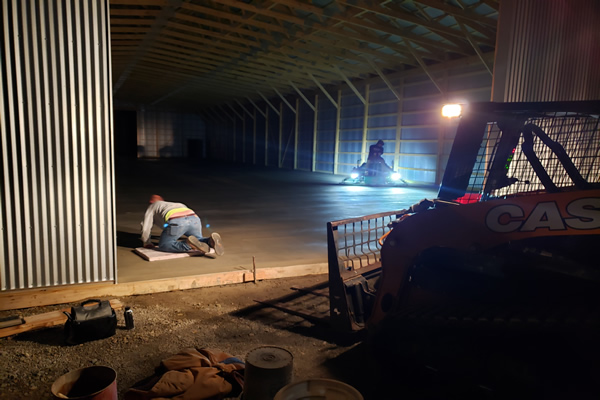

The crew finished at about midnight.

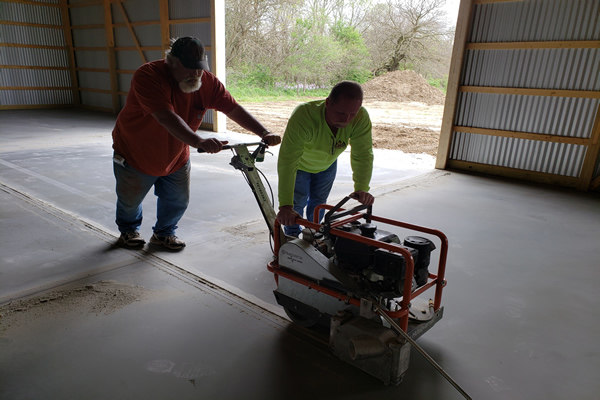

May 21st - Brady Saylor cutting expansion joints

Glen Hall & Brady Saylor

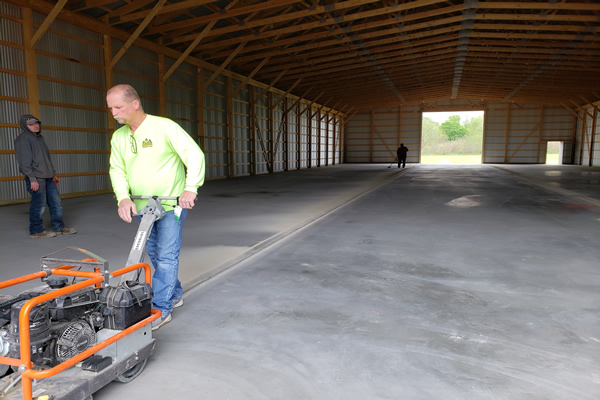

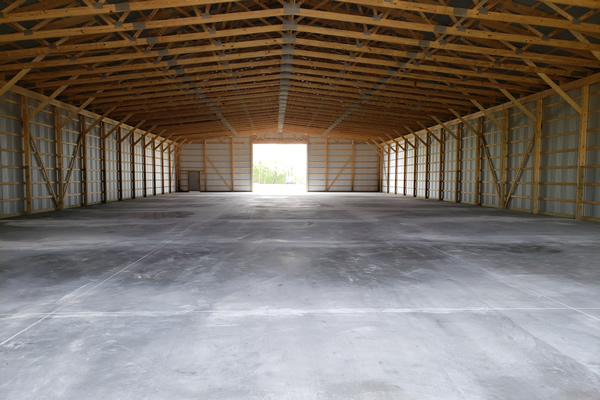

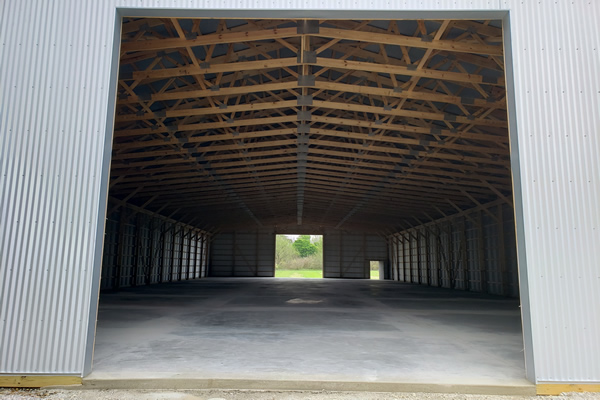

Beautifully finished concrete floors.

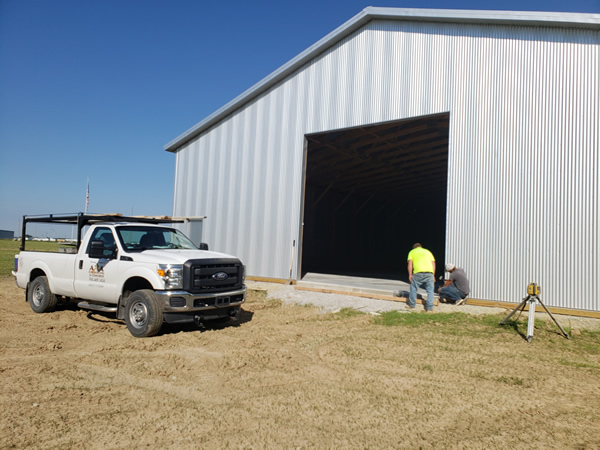

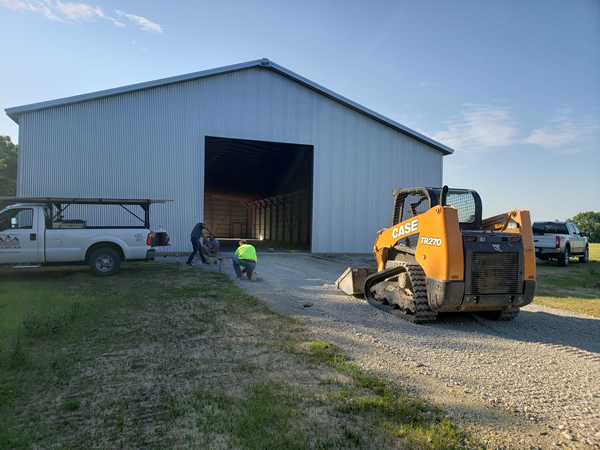

June 18th - The crew from AAA Excavation & Concrete setting the forms for the concrete approach. Front of the building.

June 18th - Forms for the approach and sidewalk. Rear of the building.

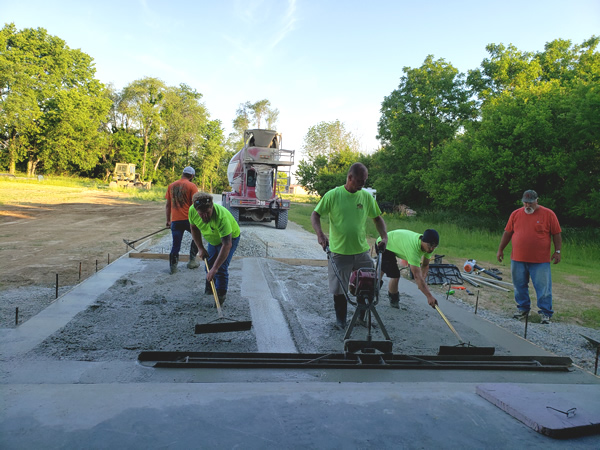

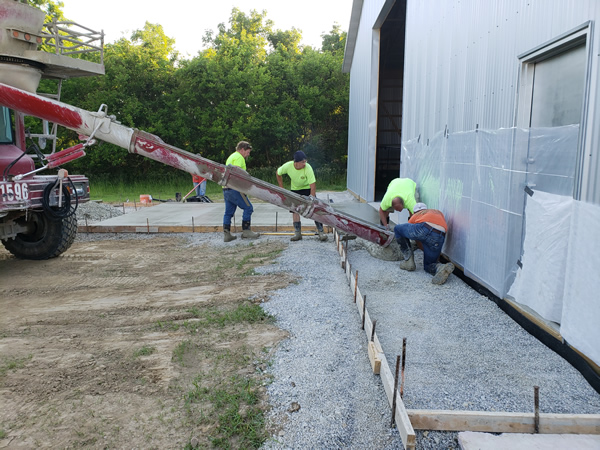

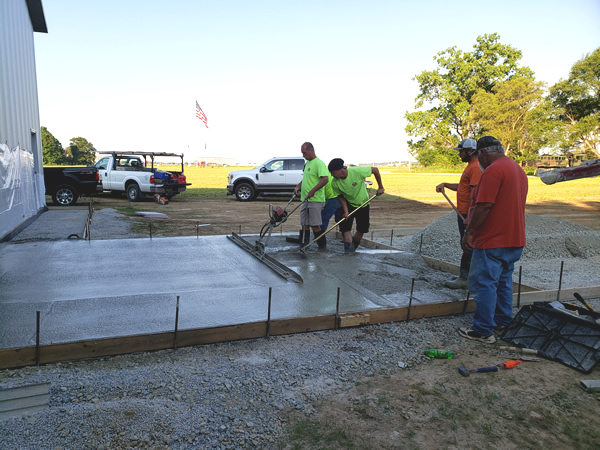

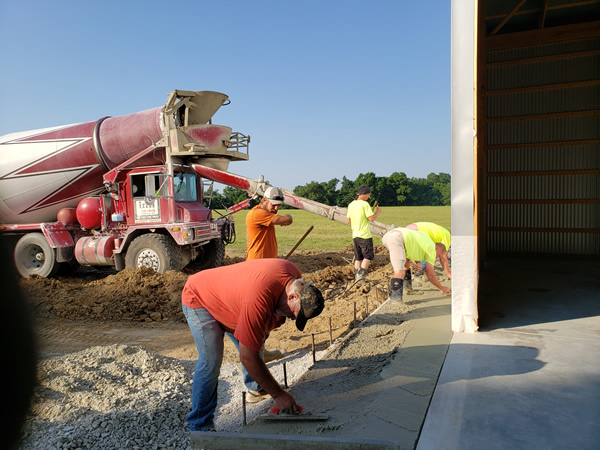

June 19th - Pouring the concrete approach.

June 19th - Front approach.

June 19th - Rear approach & sidewalk.

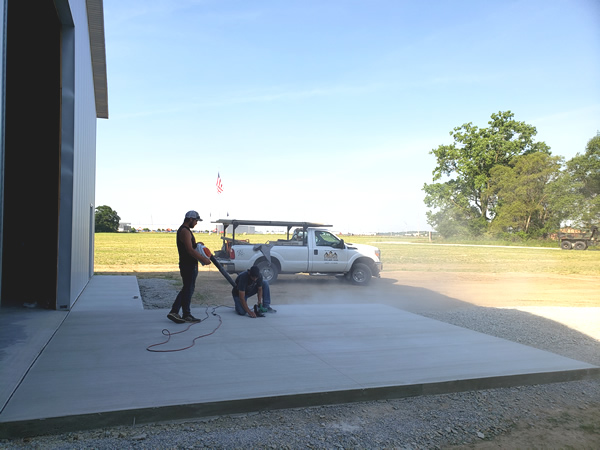

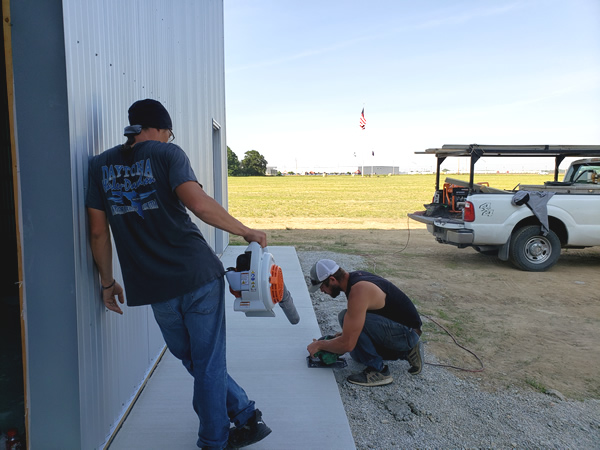

June 20th - Cutting the expansion joints

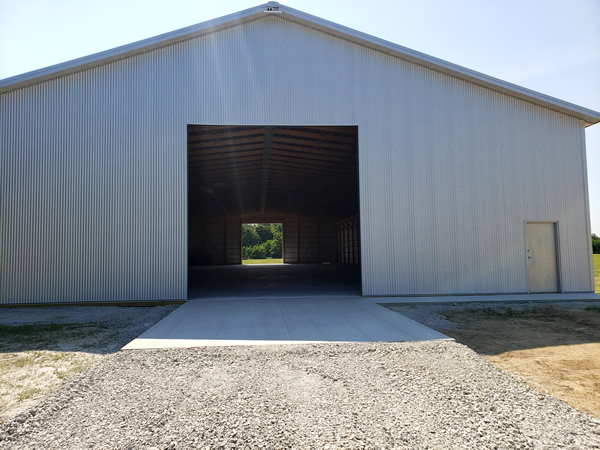

  June 20th - All the concrete work is finished. Another fine job by AAA Excavation & Concrete, JD Concrete and IMI.
